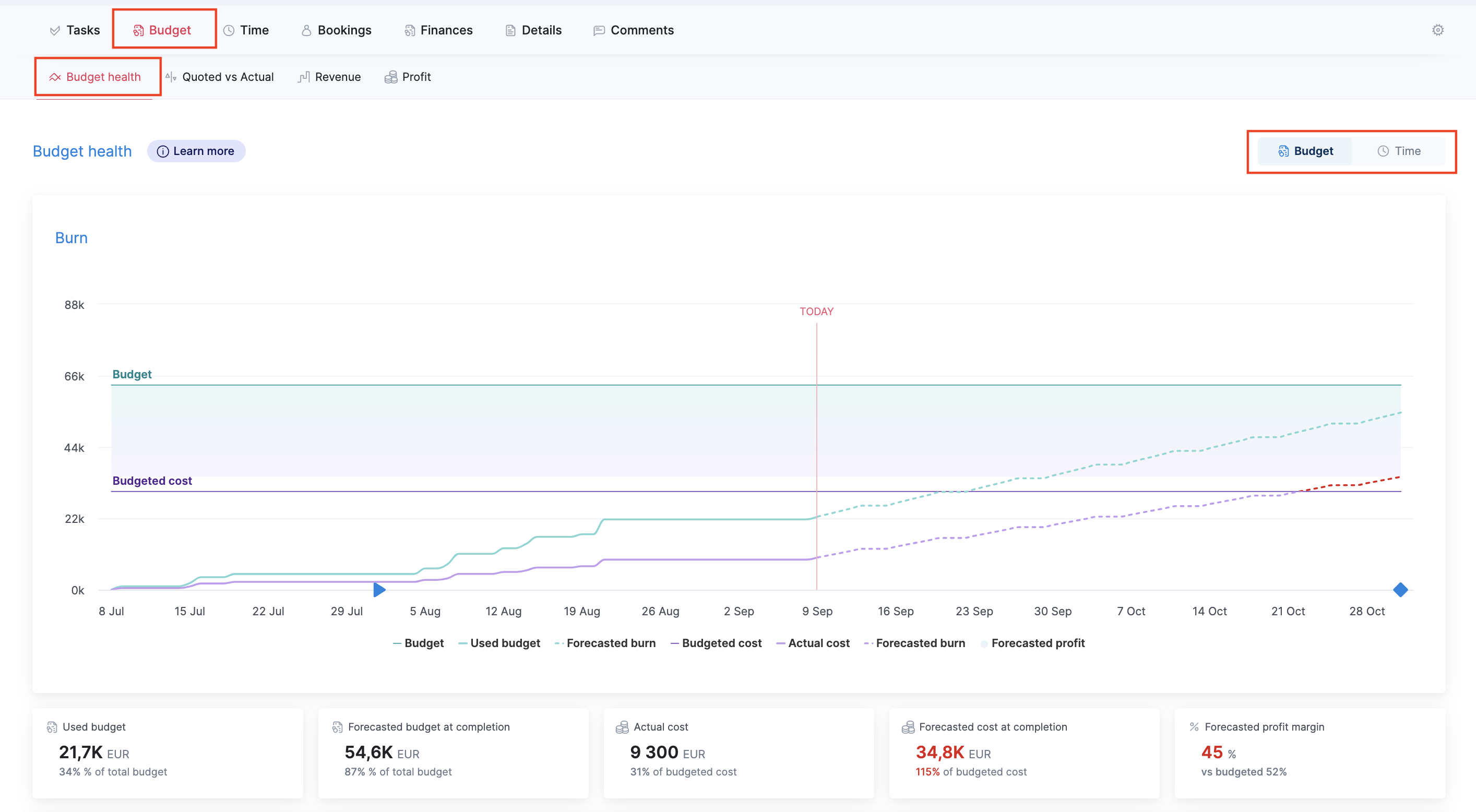

The project budget burn and breakdown charts in the project view help you track and forecast how you’re progressing against your budget in terms of time and money. Both charts are located in the Budget health section in the Budget tab.
You can toggle between Budget and Time insights. This article focuses on the data in the Budget view, i.e. the dimension that helps you track and forecast money.

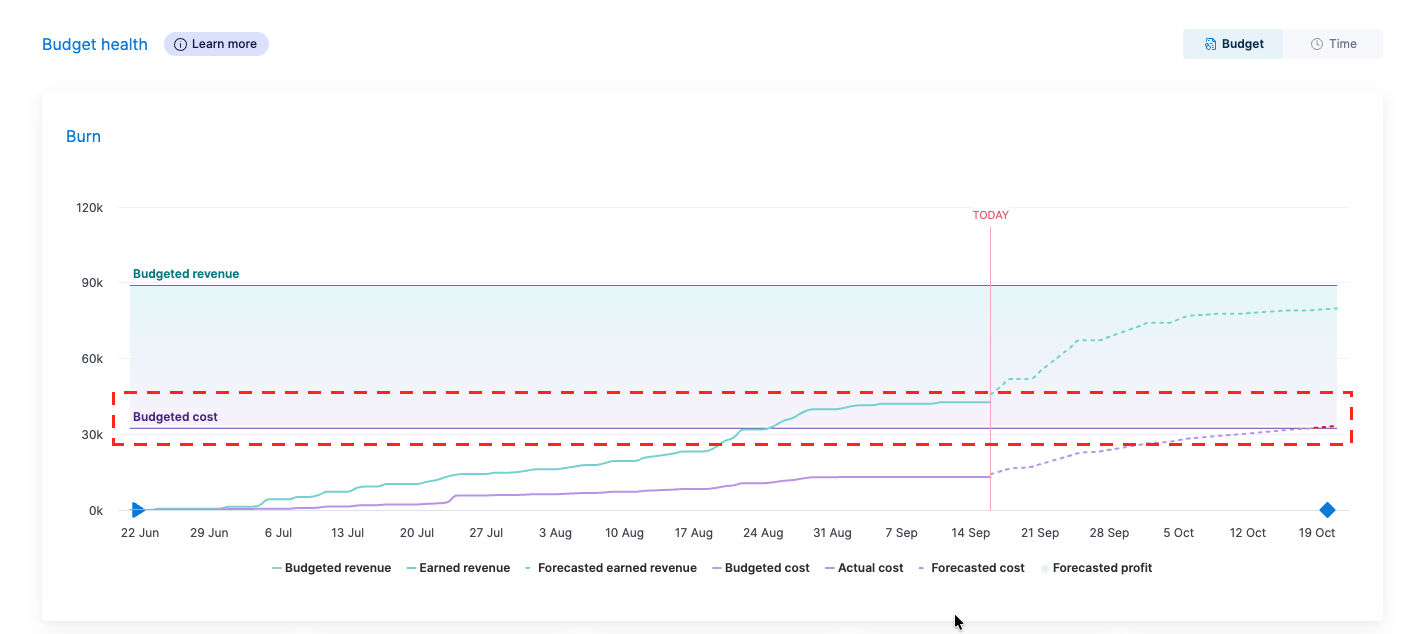

Burn chart
What is the chart for?

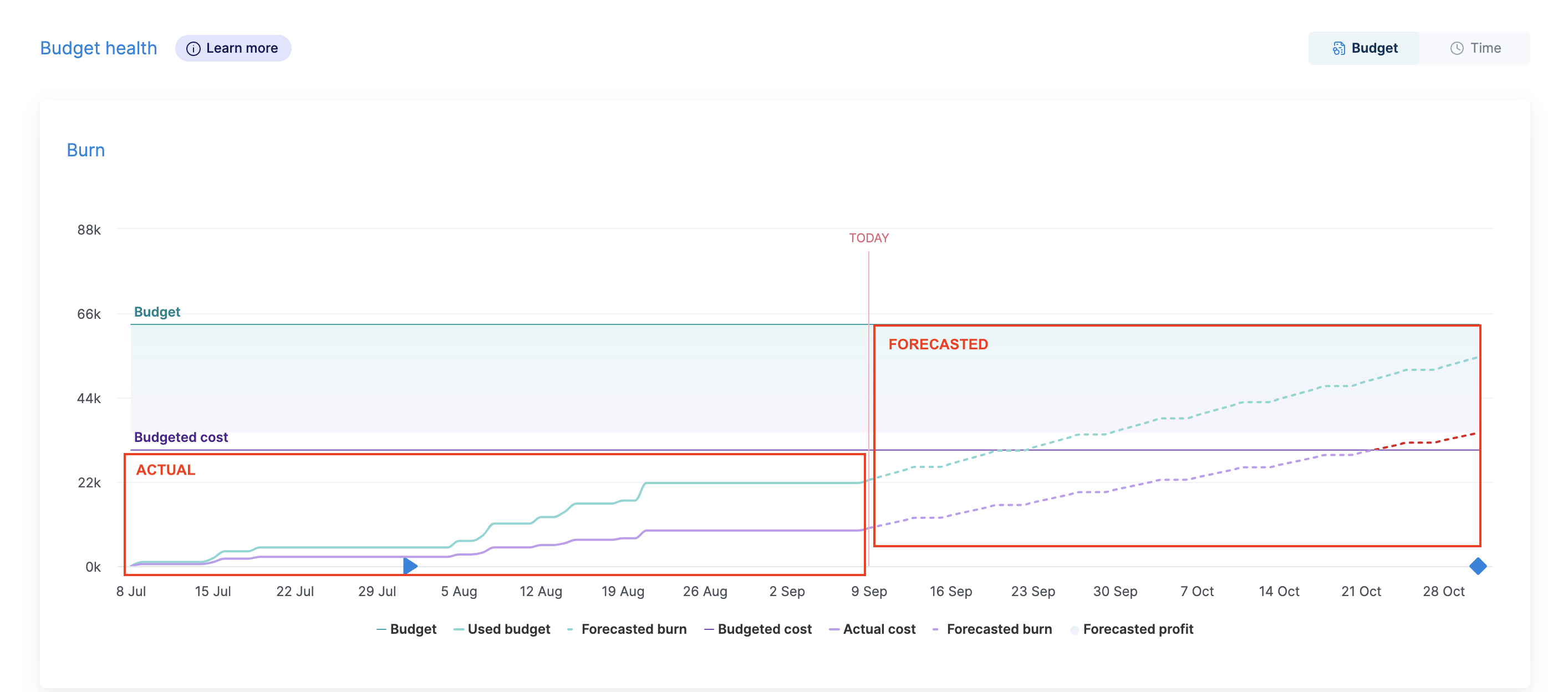

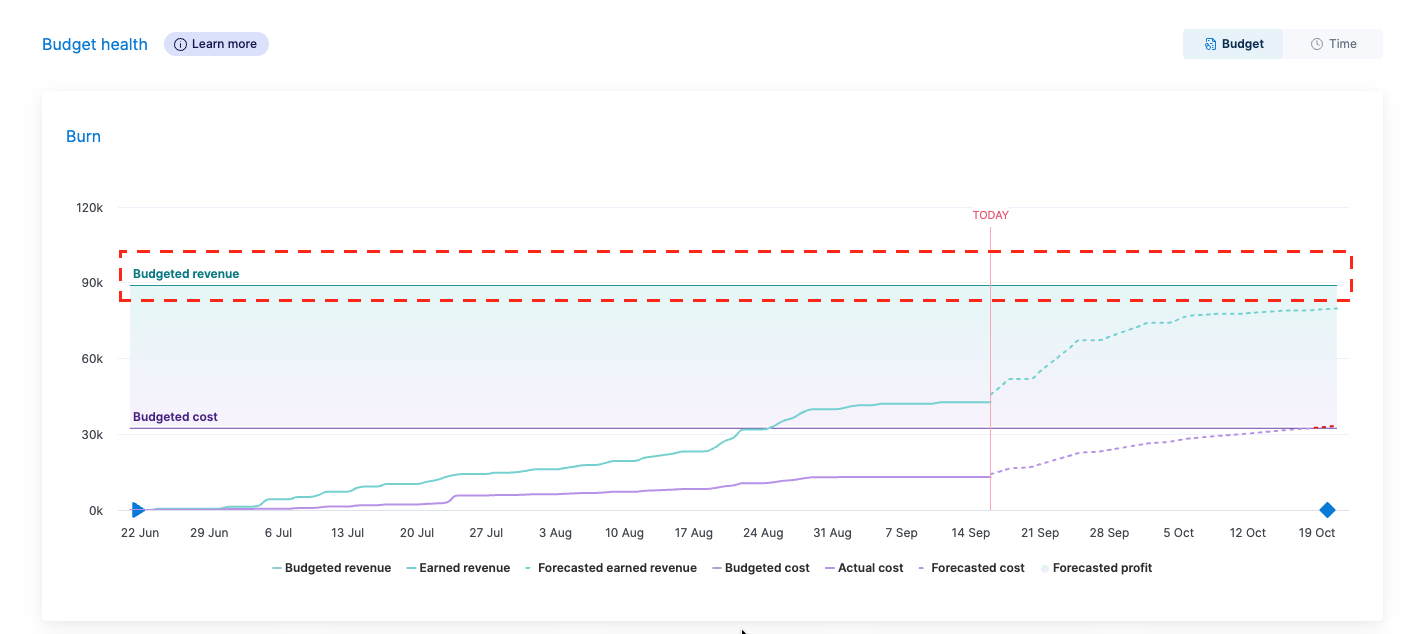

The Burn chart visualizes the budget and cost progress over the course of the project.
It helps you understand at a glance:
- how you’re progressing against the budget based on delivered and planned work
- where you're currently predicted to end up cost- and profit-wise based on work that’s still to do
As a result, you can forecast the likely profit of your project way before it ends and detect signs of overservicing early enough when you still have time to course-correct to ensure profitability.
How to read the chart?
The chart tracks two different budgets simultaneously:

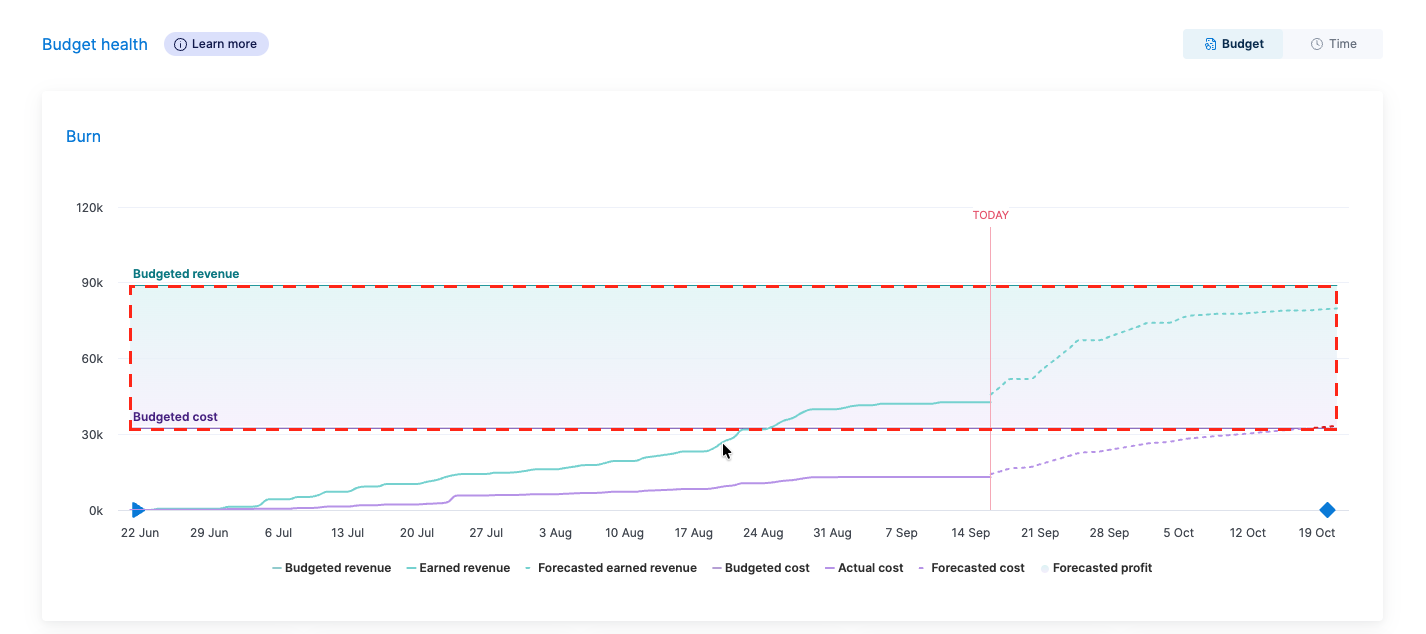

Total budget (teal line)

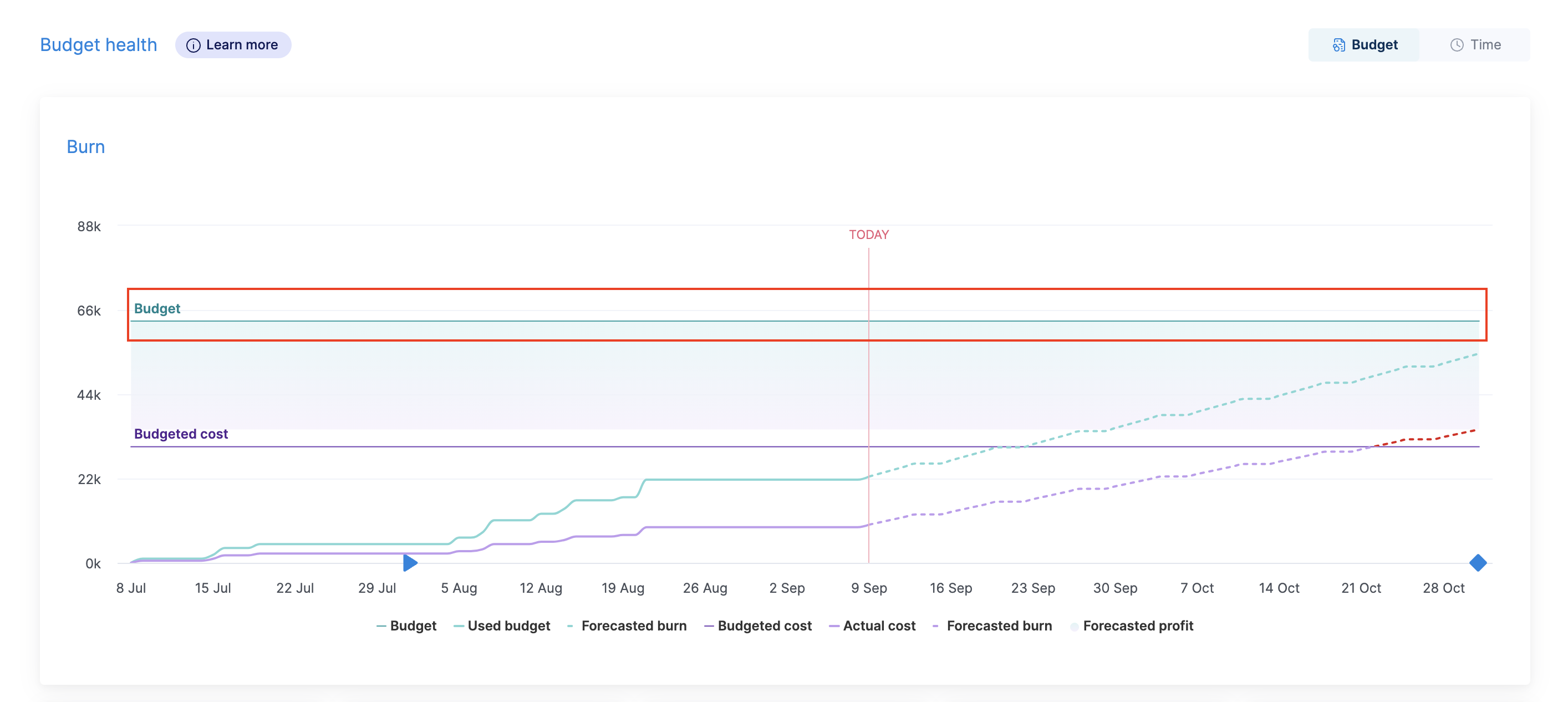

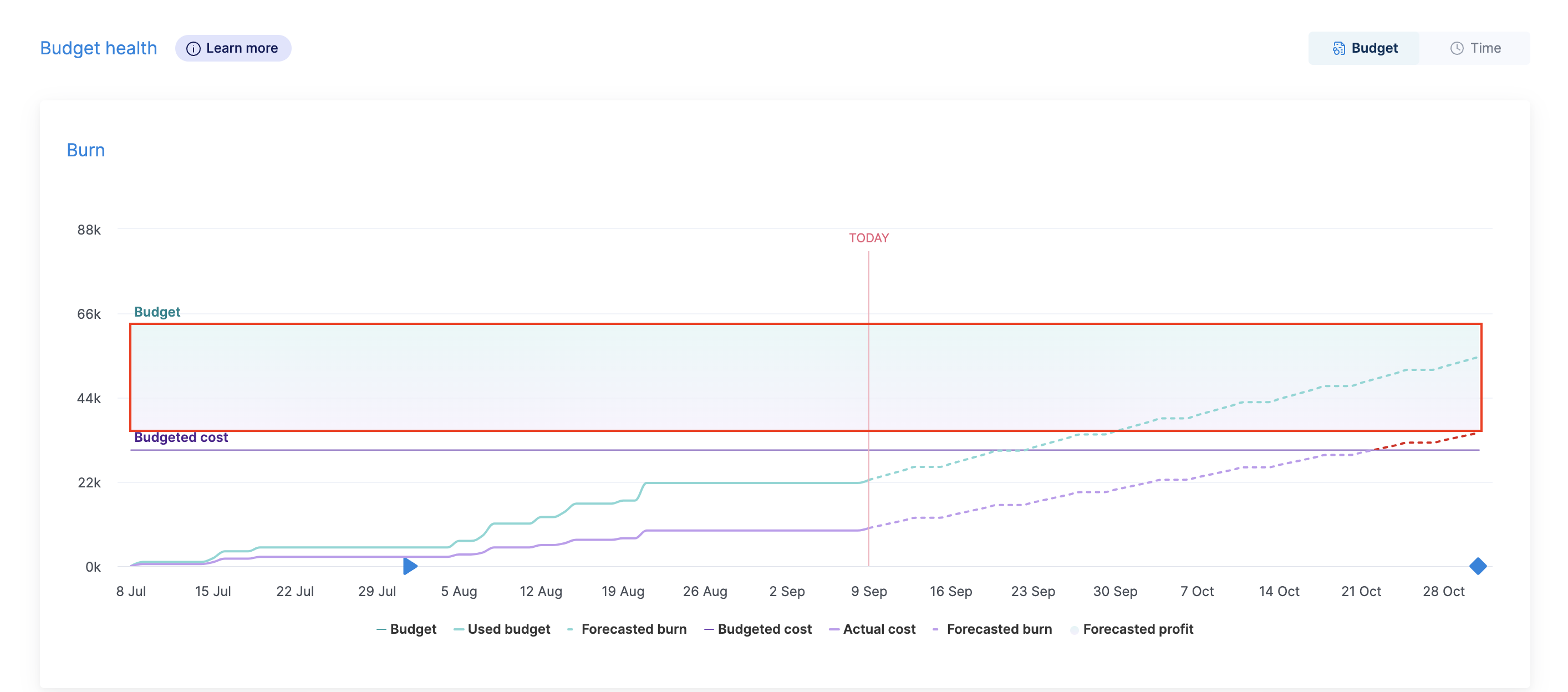

- This is the budget you agreed on with your client.
- It’s based on charge-out rates.
- Formula: budgeted hours x selling price
- Ideally, you've already accounted for a profit within that budget. To turn a profit, you need to keep your costs under control, so this is where the cost budget comes into play.

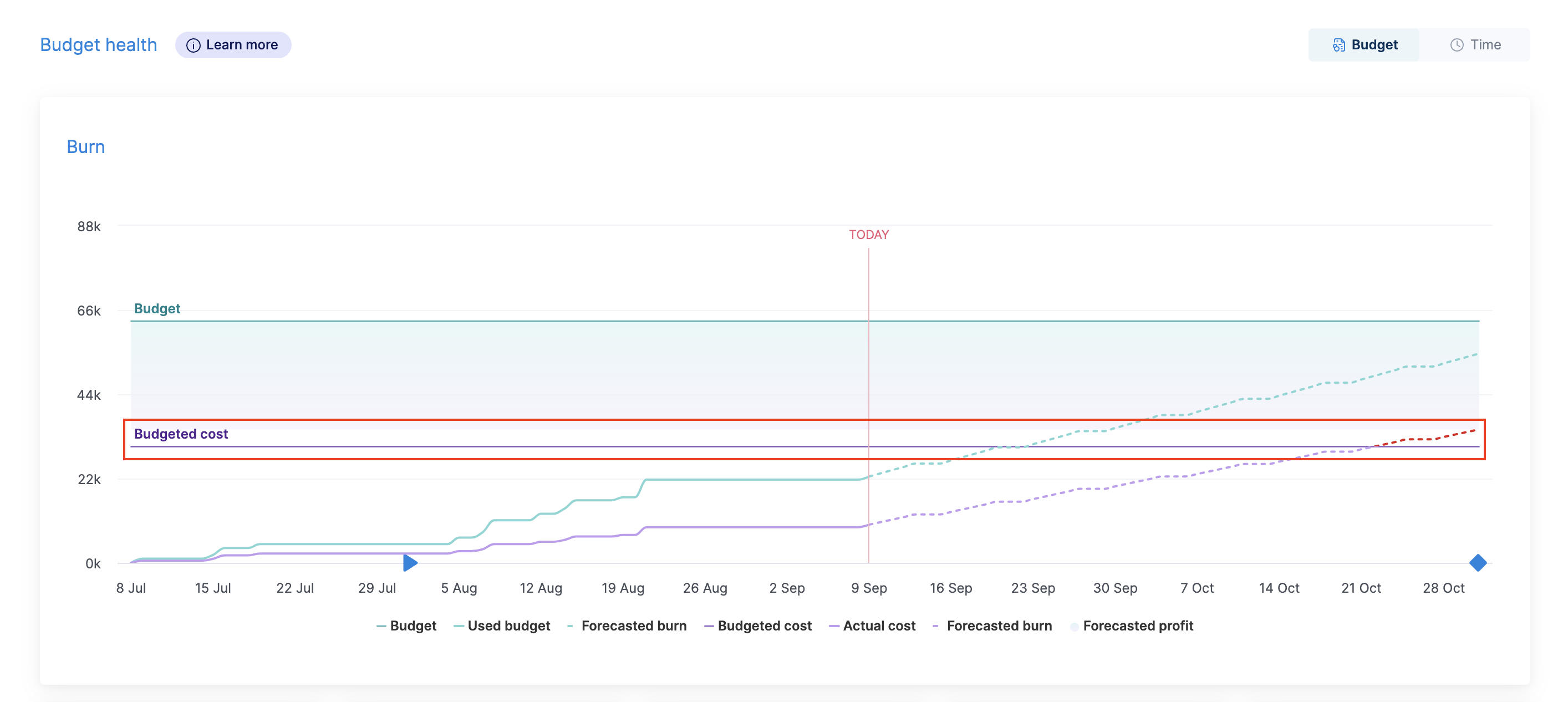

Budgeted cost (purple line)
- This is your cost budget. It's for internal cost tracking and indicates how much you plan to spend on resources to actually deliver the work.
- It’s based on internal cost rates.
- Formula: budgeted hours x internal cost
- It shows how much the delivery will cost you as a business. It takes into account in-house and outsourced work.
So, in the end: total budget – actual costs at completion = your profit.
The gradient area on the map helps to visualize the forecasted profit based on this data.
The chart tracks two different dimensions for both budget lines:

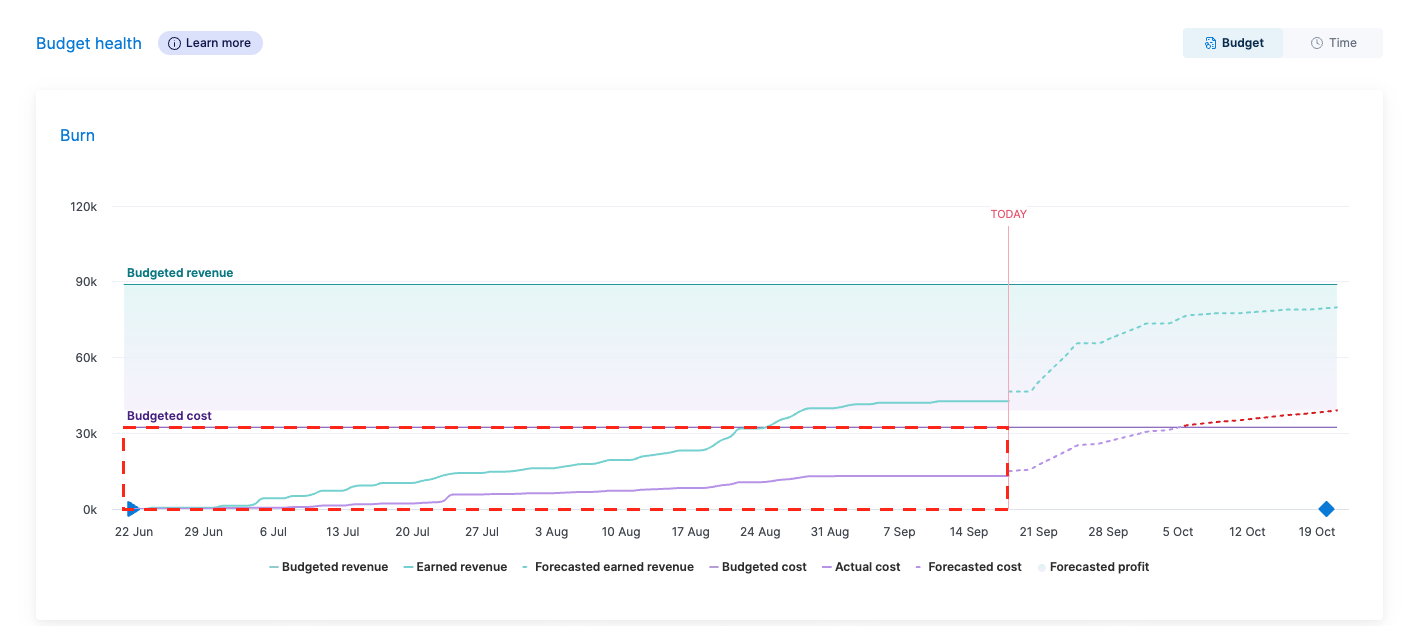

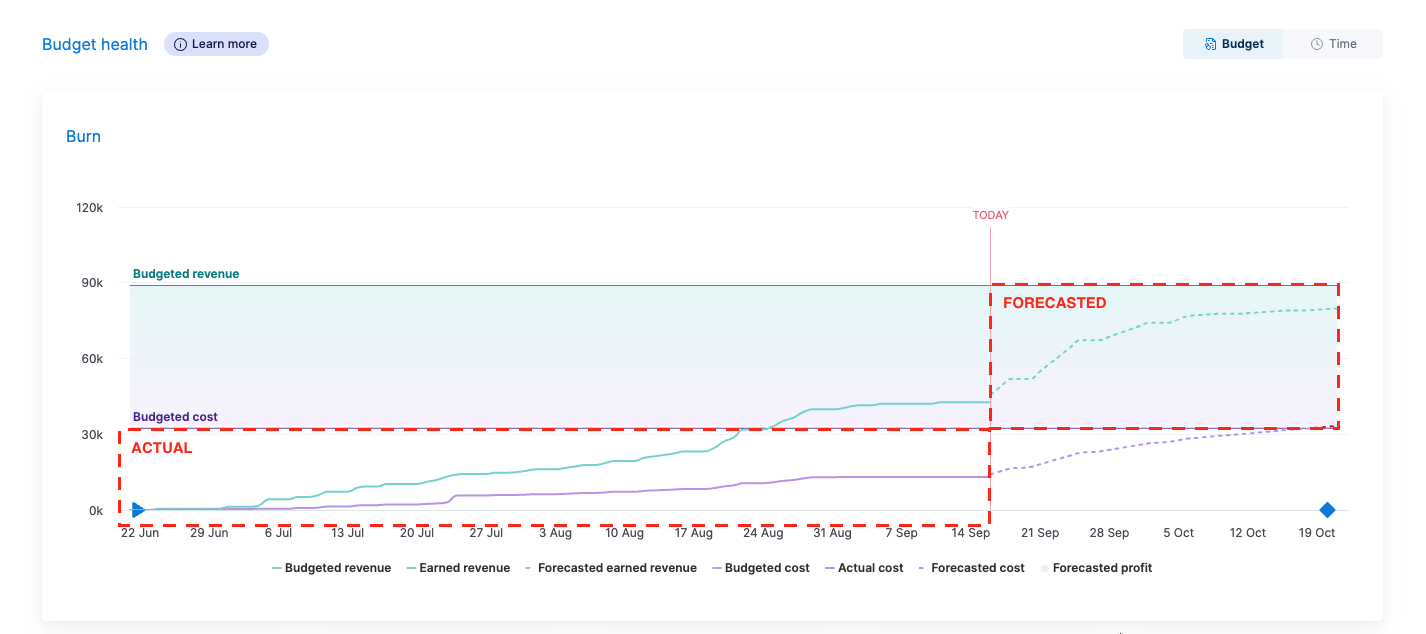

- Actual burn up to date (continuous line) – shows you actual progress based on work you've already completed.

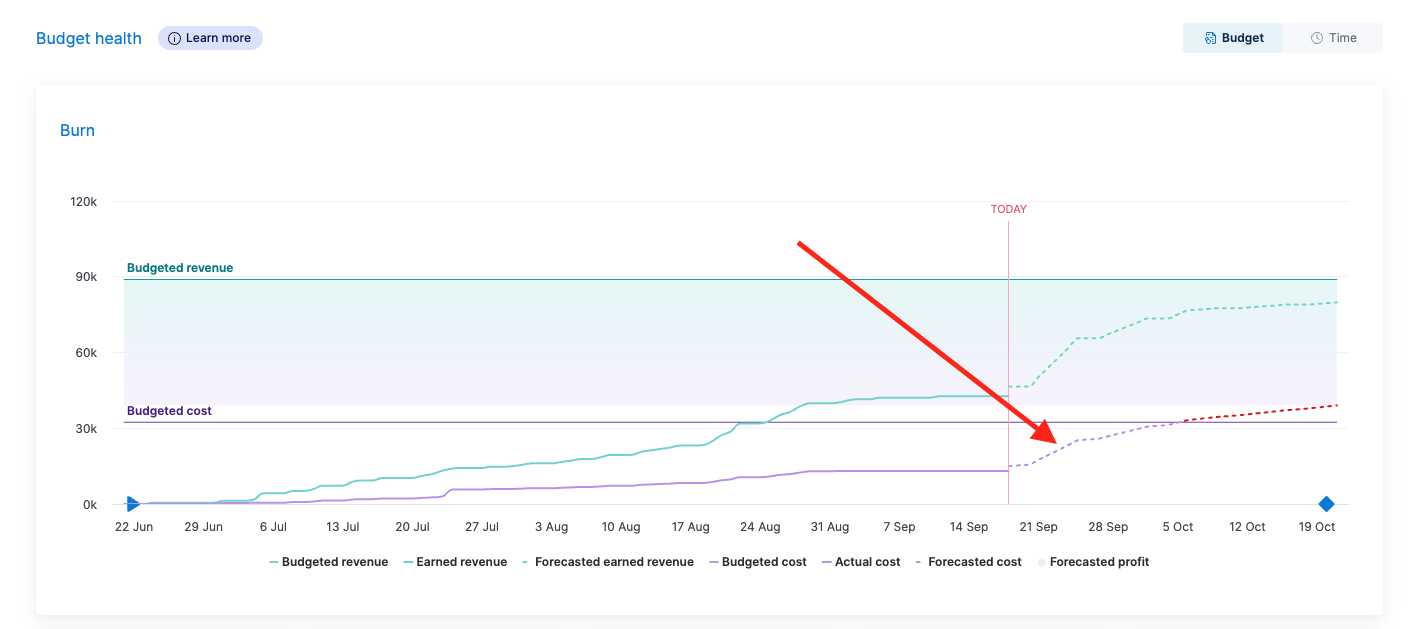

- Forecasted burn (dotted line) – shows you how much budget you will still need to complete all the work you’ve planned.

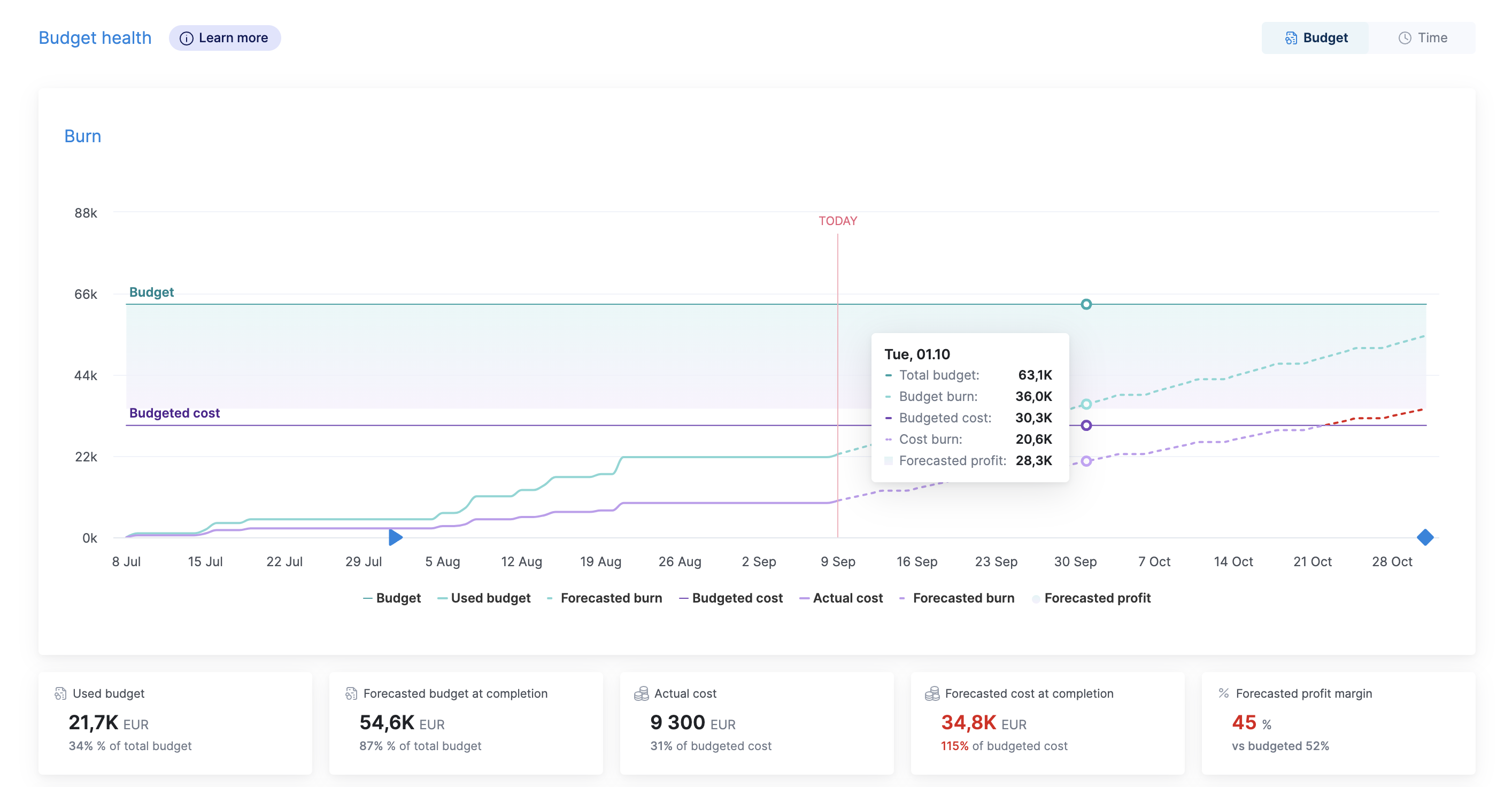

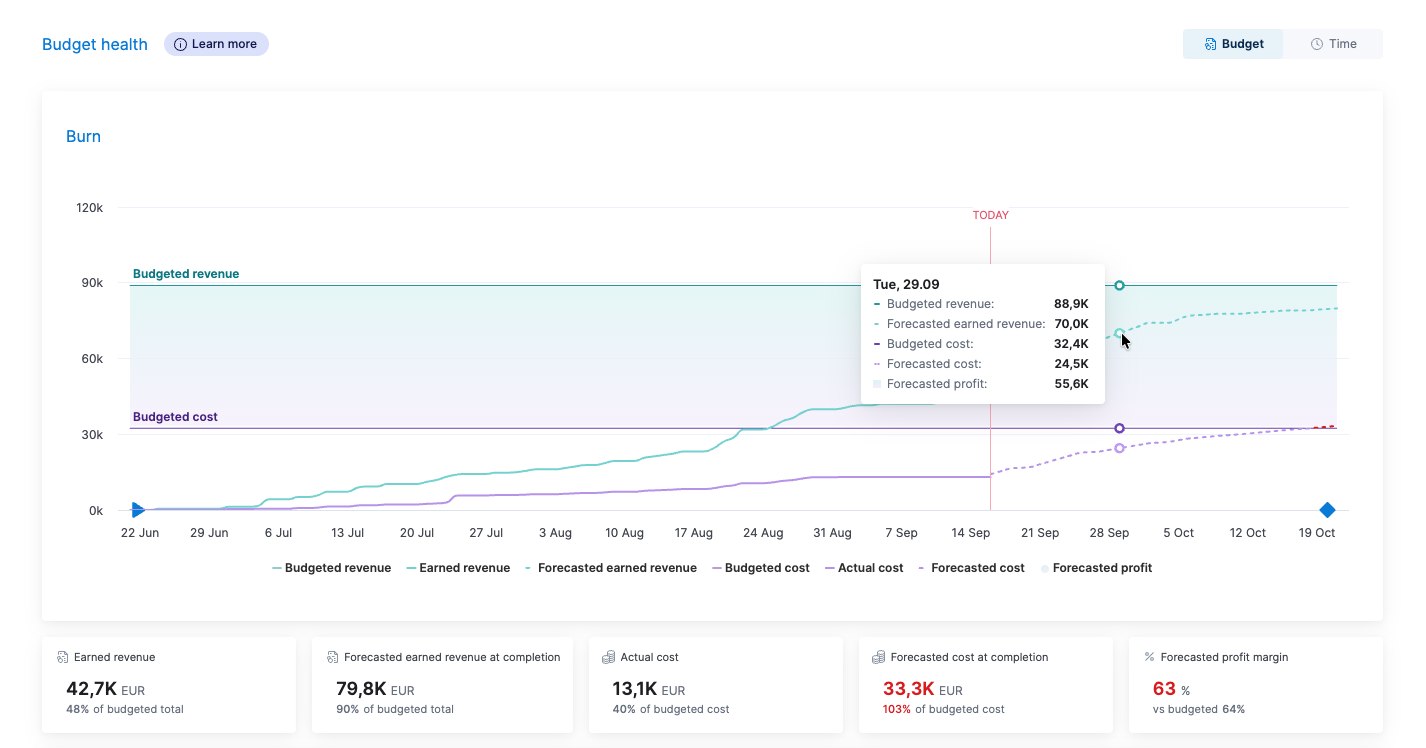

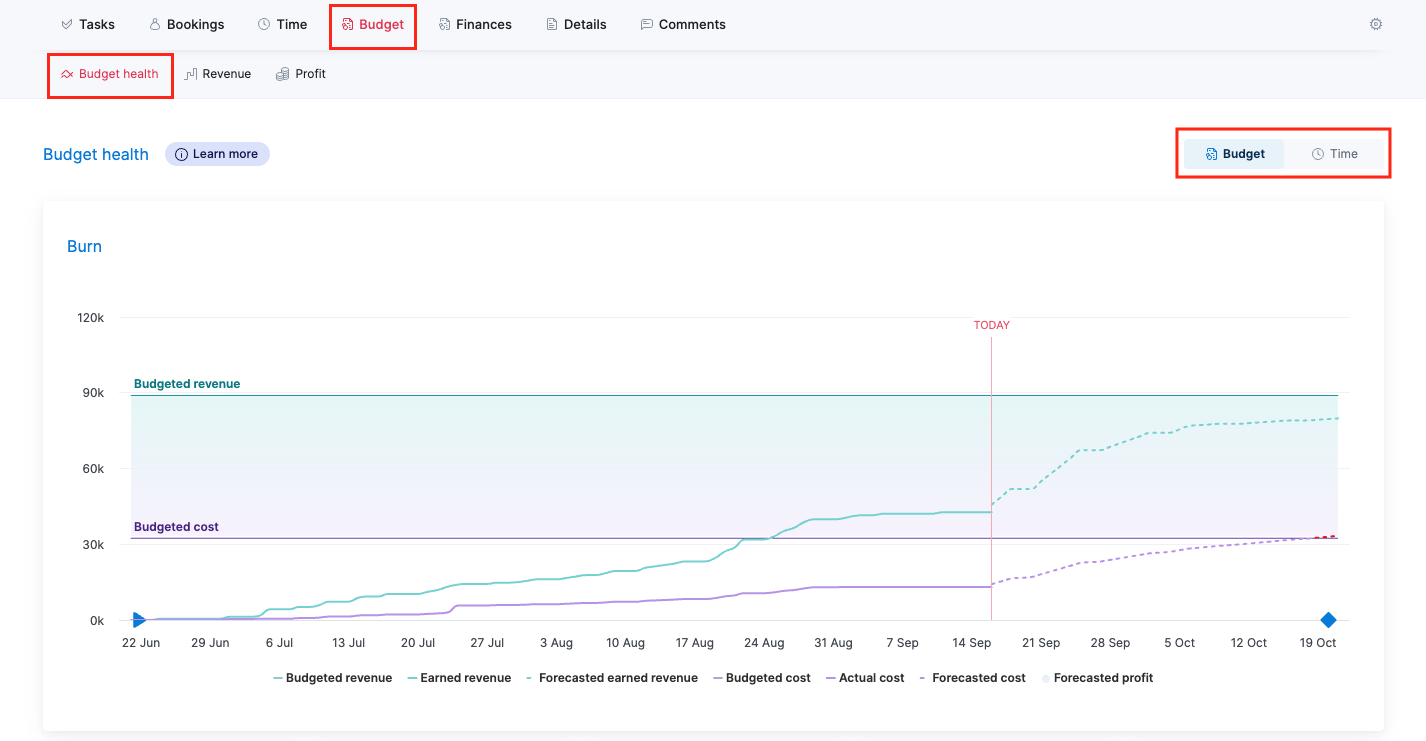

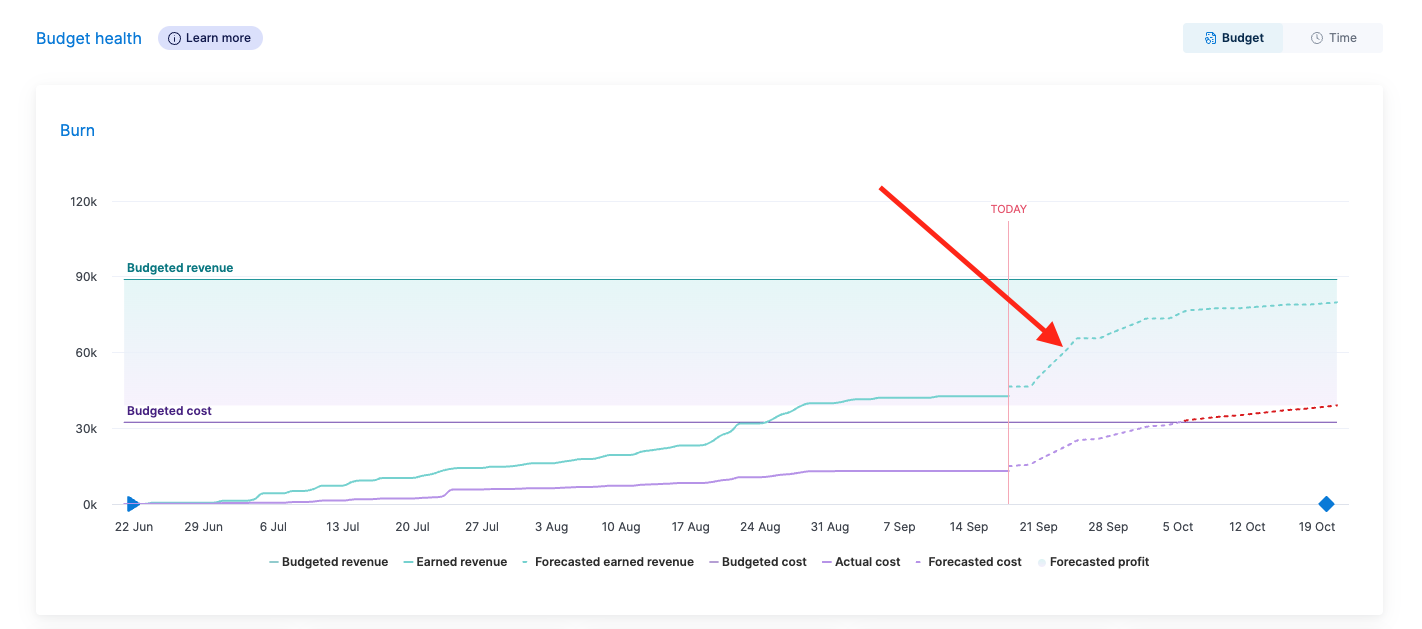

You can hover over the lines to see the exact accumulated budget and cost numbers for that day. If you want to get a deeper understanding of the formulas behind those lines, check out the Advanced section below.

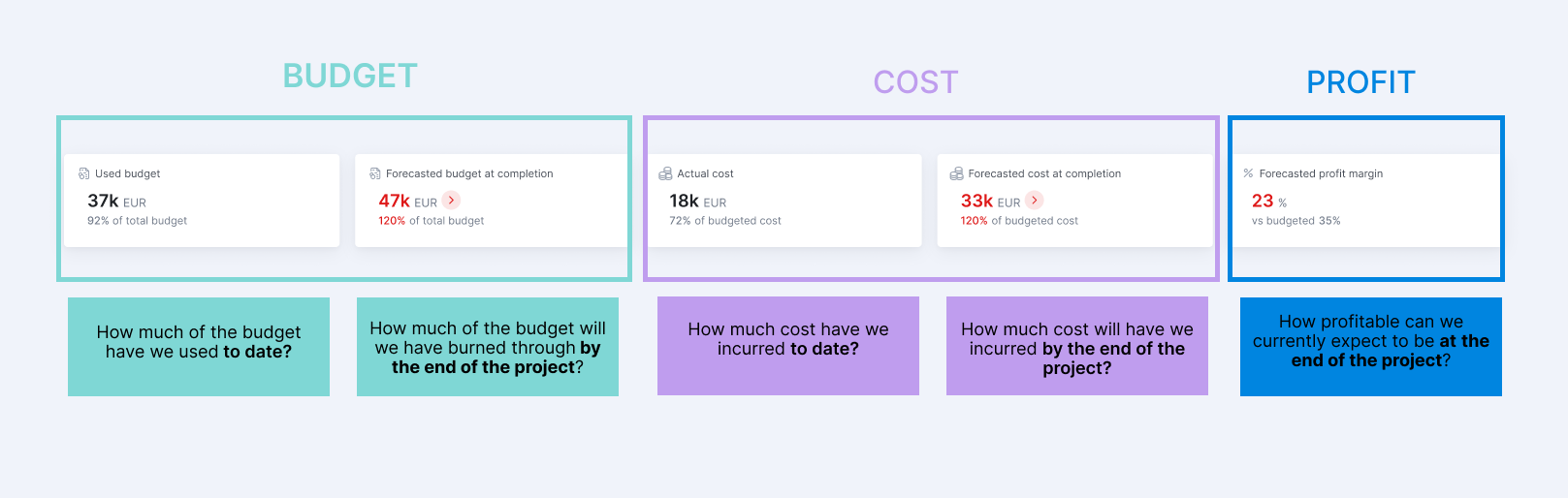

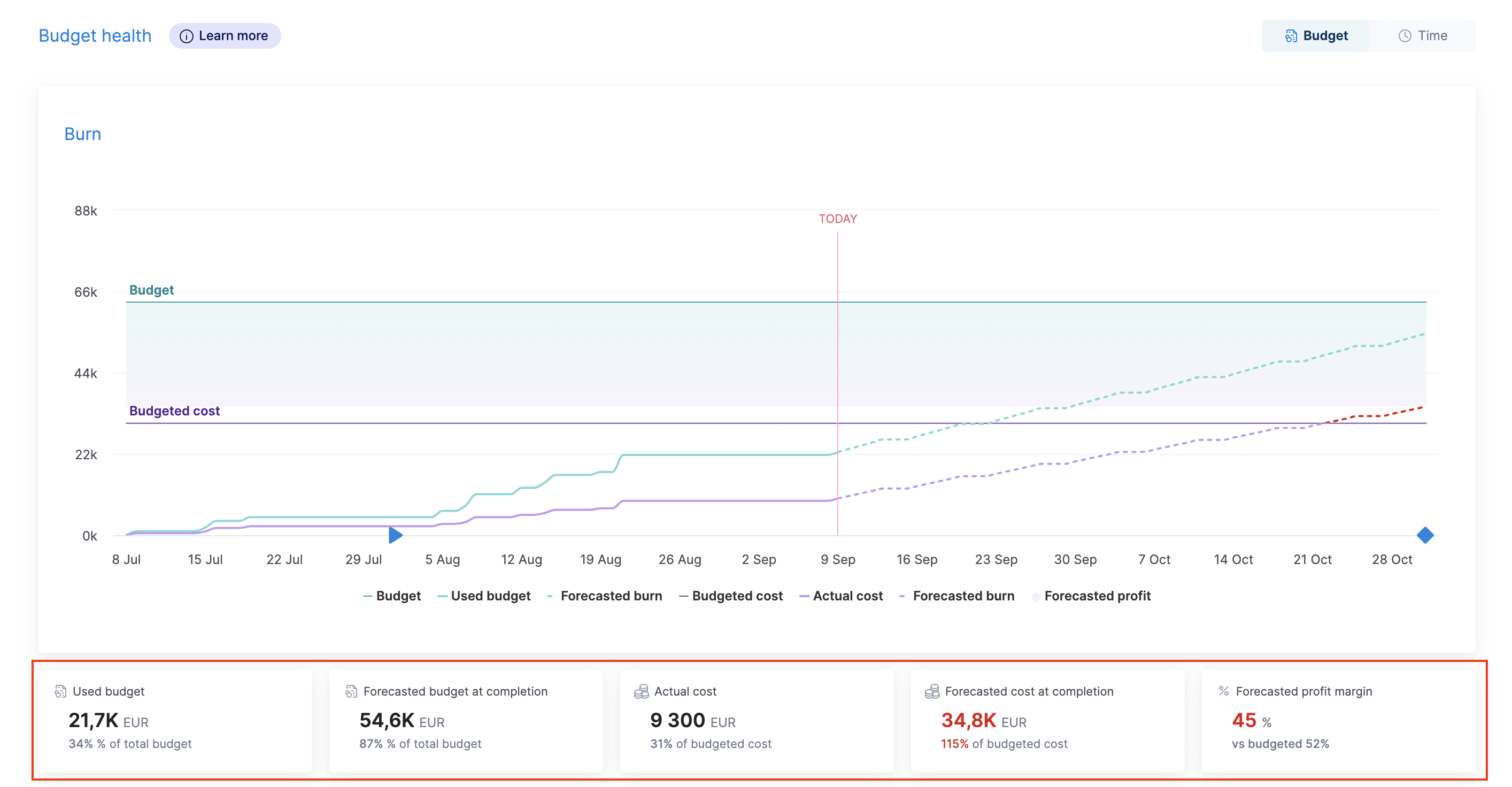

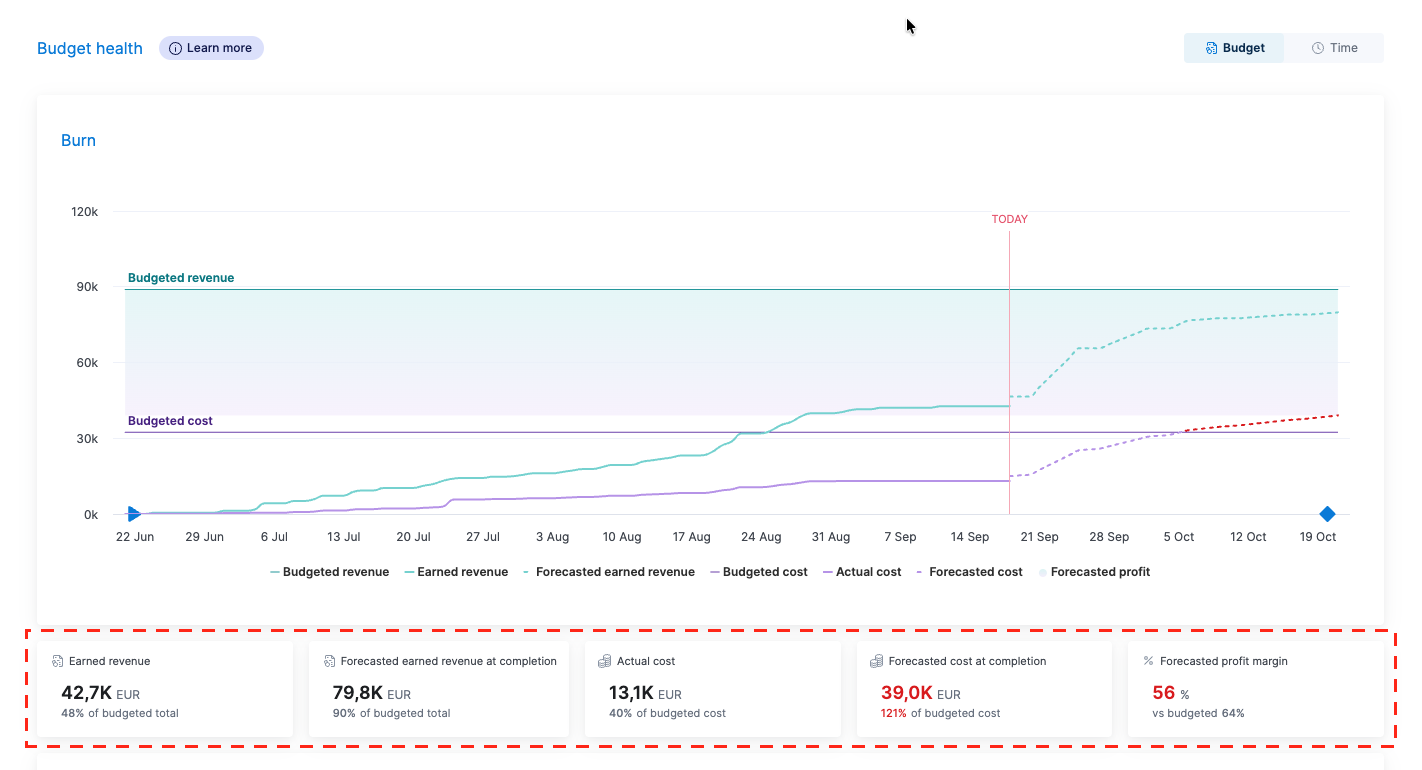

The metrics cards below the burn chart summarize the key data in numbers:
They help you answer the following questions at a glance:

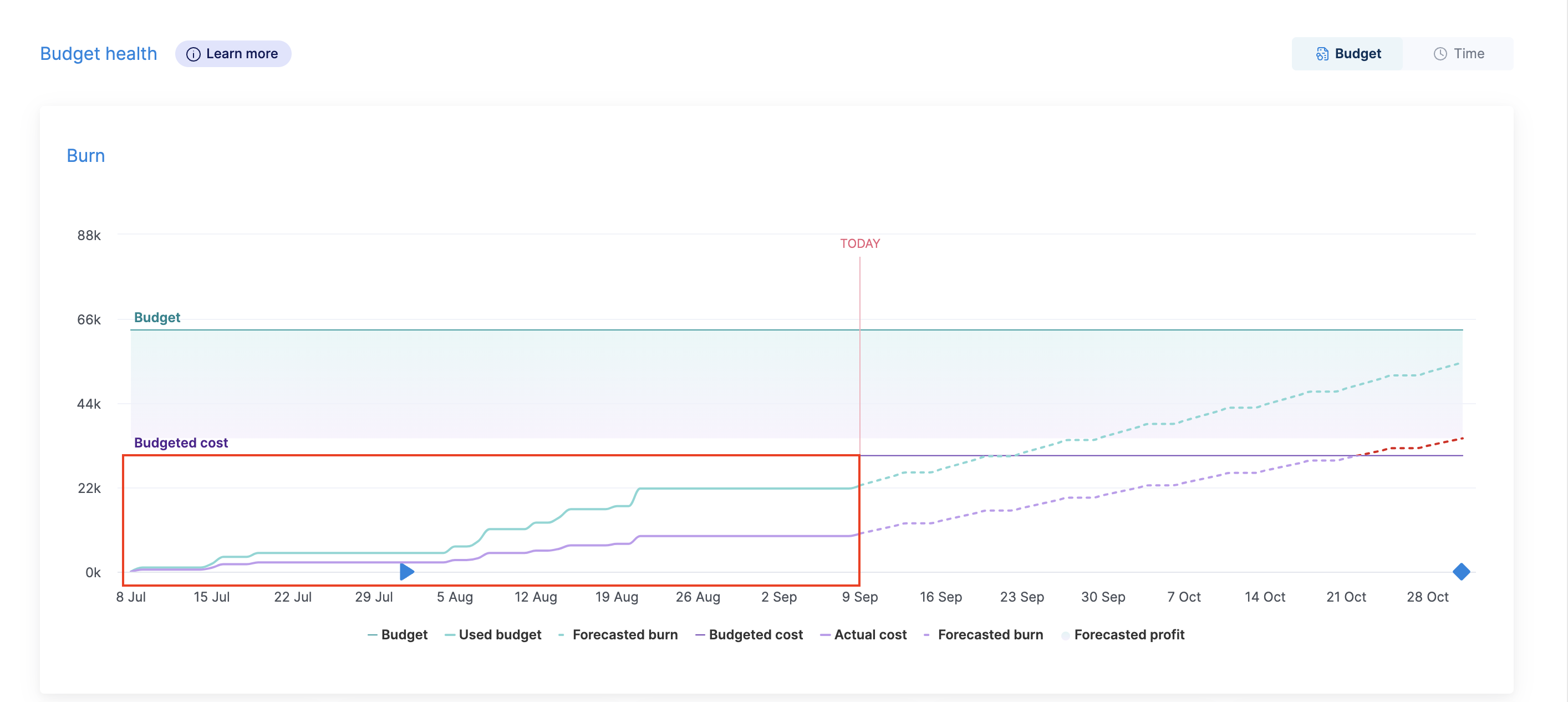

The chart itself covers the whole project timeframe. The project timeframe is not limited to project start and end dates. It’s defined by project-related activities. In other words – if any task, time entry, or event falls outside of the project start and end dates, the displayed project period will be extended accordingly.
Things to keep in mind:
- With retainer projects, the burn chart shows data only for the current period.
- Tasks marked as “personal” are excluded from the chart.

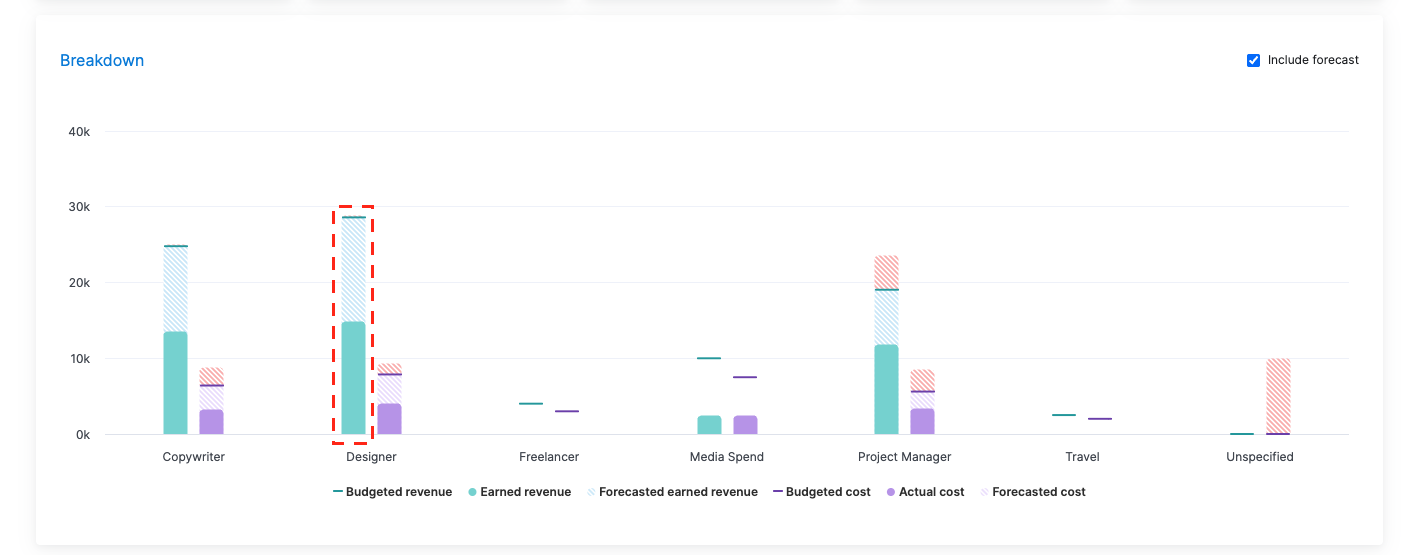

Breakdown chart
What is the chart for?

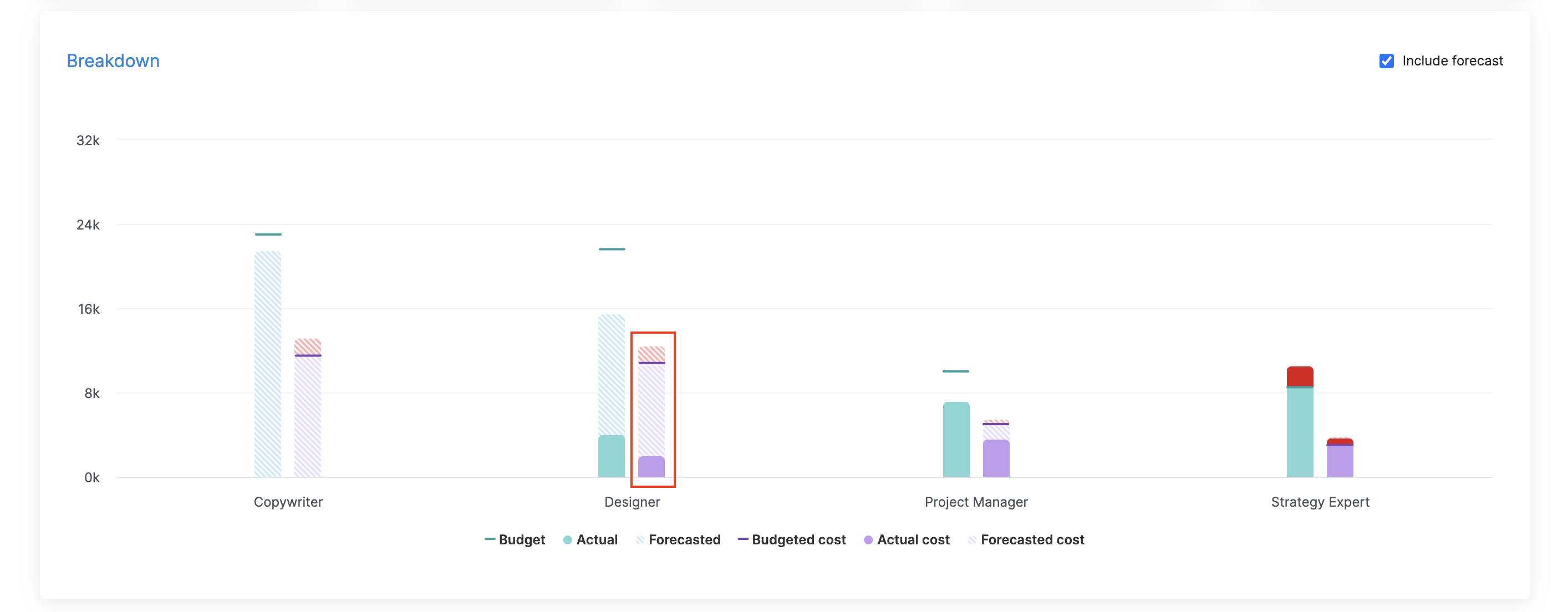

The Breakdown chart shows you how your budget and costs are distributed across roles or services and where you’re likely to end up at the current pace.
Role-based prices | The chart breaks the budgets down by roles and outsourced services. |
Service-based prices | The chart breaks the budgets down by services. |
The breakdown chart can help you pinpoint what’s making your costs run over – if any of the bars turn red, it’s a clear sign you’re either:
- overutilizing some of the roles
- using too expensive resources
- putting in too many hours to deliver certain services
Based on this info, you can tackle the problematic role or service to protect your profit.

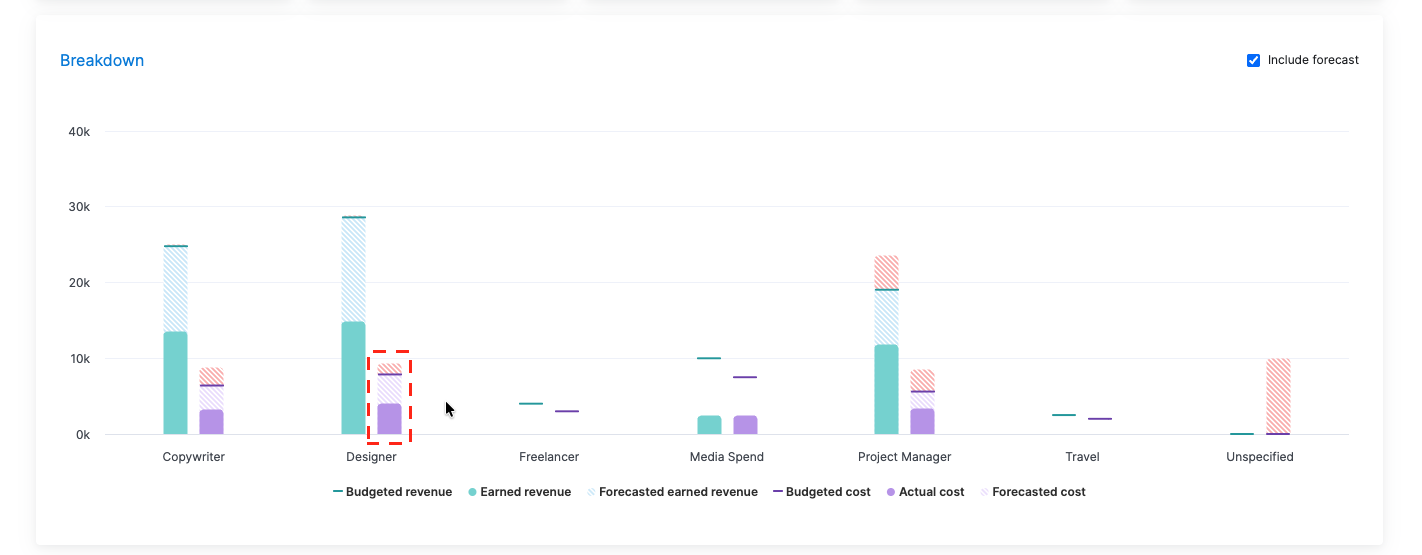

How to read the chart?
Scoro tracks two different dimensions for each role/service:
Total budget (teal bar on the left)
- This tracks the budget you've allocated for that role/service. The teal line indicates the budget limit.
- It’s based on chargeout rates.
- Solid color indicates actual budget burn based on completed work.
- Striped part indicates the forecast based on planned work.
Budgeted cost (purple bar on the right)
- This is the cost dimension. It shows you how much you planned to spend on that particular role/service to deliver the work. The purple line indicates the budgeted limit.
- It’s based on internal cost rates.
- Solid color indicates costs incurred to date based on completed work.
- Striped part indicates the forecasted costs based on planned work and bookings.

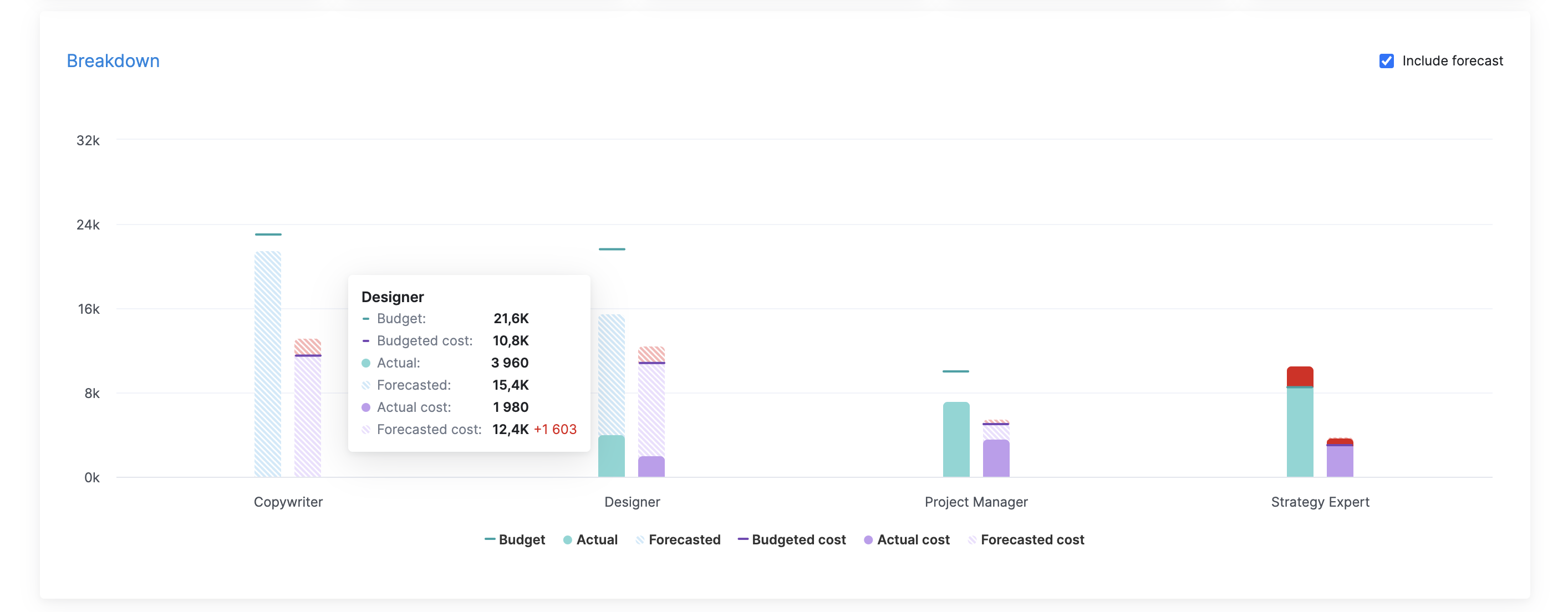

Each role or service will only have one bar on the chart. If the same role/service is used for several quote lines, the data will be merged. In case of multiple quotes, the totals for each role will also be merged into a single bar. Keep in mind that only successful quotes are taken into account.
Things to keep in mind:
- With service-based prices, you need to either
- 1) create the task directly from the quote line, or
- 2) link the task to the correct activity type
as Scoro uses this info to connect the task and its progress with the right service on the chart
- With role-based prices: when a person logs time under a task that’s assigned to some other role, the logged time still counts towards their own role. For example, if a design task is assigned to a Senior Designer, but a Project Manager logs 30 minutes under it, these 30 minutes will be reflected in the progress bar of the ‘Project Manager’ role.
- With retainer projects, the burn chart shows data only for the current period.
- Tasks marked as “personal” are excluded from the chart.
Advanced
Retrospective data
The retrospective lines on the burn chart, which track actual data to date, are based purely on completed work.
In-house:
Budget line:
- Logged hours x the selling price = used budget to date
- Each event and time entry is reported on the completion date
Cost line:
- Logged hours x labor cost = actual cost to date
- Each event and time entry is reported on the completion date
Outsourced:
Budget line:
- Outsourced cost is reported on the budget line only once it has been invoiced to the client, i.e. you've created an invoice from that bill to pass the cost to the client.
- The invoiced sum is reported on the invoice issue date.
Cost line:
- Bill or expense is reflected on the recognition or issue date
Budget forecasting logic
This paragraph digs deeper into how the budget forecast line is formed on the burn chart.
In-house work
The budget forecast is based on the remaining time of planned tasks.
Budget calculation | Budget distribution | |
Future time entry | Duration x selling price | On the day of the time entry |
Future task |
Remaining hours x selling price |
Depends on when the task is created and whether it has a concrete start and/or end date. See the detailed logic in the table below. |
If you've enabled billable time for your site, only the billable hours are counted in the budget forecast, as only these generate revenue for you.
Task distribution logic:
Start date | Due date | Budget distribution |
Future | Future | Distributed equally from task start date to task due date |
Past | Future | Distributed equally from the current date until the task due date |
- | - | Distributed equally over the remaining timeframe* of the project |
- | Future | Reported on a single day – the future due date |
- | Past | Distributed equally from the current date until the project end |
Future | - | Distributed equally from the future start date until the project end |
Past | - | Distributed equally from the current date until the project end |
Past | Past | Distributed equally from the current date until the project end |
*The project timeframe is not limited to project start and end dates. It’s defined by project-related activities. In other words – if any task, time entry, or event falls outside of the project start and end dates, the project period will be extended accordingly.
Outsourced work
Outsourced cost is reported on the budget line only once it has been invoiced to the client. The invoiced sum is always reported on the invoice issue date. Therefore, outsourced work is most likely reflected in the retrospective data unless the invoice issue date is still in the future.
Cost forecasting logic
This paragraph digs deeper into how the cost forecast line is formed on the burn chart.
Scoro forecasts the project’s future cost based on planned in-house work and planned outsourced purchases. Even if you haven't planned any work yet, Scoro still tries to give you a rough estimate with the little data it has to be as helpful as possible.
At the same time, Scoro refrains from painting a picture that is too optimistic. For example, if you have defined a cost budget, the cost forecast on the burn chart will always be at least as high as your budgeted cost. Scoro always assumes you will incur these costs. This helps to protect you from an overly optimistic profit forecast early in the project when most of the work is not planned yet. The cost forecast will go red once you start exceeding your budgeted costs as this is the news you can react on.
Data that affects the cost forecast:
Reference line: | |
Budgeted cost | Taken from the quote or from the manually set budget |
In-house costs: | |
Labor cost | Default, role-based, or user-based labor cost |
Bookings | Both tentative and fixed bookings are considered future cost |
Tasks | The remaining time of the task is considered as future cost |
Scheduled time entries | Future time entries help to distribute the tasks’ remaining time and are therefore also considered as future cost |
Outsourced costs: | |
Cost documents | Bills, expenses, POs |
In-house costs
In-house costs are affected by:
- Tasks and time entries
- Bookings
Both are taken into account as they are signs of future cost. However, since they essentially reflect the same cost – a two-hour booking should eventually result in two hours' worth of tasks assigned to that same resource – the system is smart enough not to double-report them.
We’ll dive more into that in the Bookings vs tasks paragraph below, but first, let’s see how both of them affect the cost forecast line independently.
Tasks and time entries
With task and time entries, Scoro assumes that every future minute will generate cost, whether billable or not. Why? Because even if you don’t bill the client for something, it’s still a cost for your business.
Cost calculation | Cost distribution | |
Future time entry | Duration x assignee labor cost | On the day of the time entry |
Future task |
Allocated hours x assignee labor cost |
Depends on when the task is created and whether it has a concrete start and/or end date. See the detailed logic in the table below. |
Task costs are distributed across the workdays that dall within the task duration.
Task distribution logic:
Start date | Due date | Future cost (i.e. the remaining time) distribution |
Future | Future | Distributed equally from task start date to task due date |
Past | Future | Distributed equally from the current date until the task due date |
- | - | Distributed equally over the remaining timeframe* of the project |
- | Future | Reported on a single day – the future due date |
- | Past | Distributed equally from the current date until the project end |
Future | - | Distributed equally from the future start date until the project end |
Past | - | Distributed equally from the current date until the project end |
Past | Past | Distributed equally from the current date until the project end |
*The project timeframe is not limited to project start and end dates. It’s defined by project-related activities. In other words – if any task, time entry, or event falls outside of the project start and end dates, the project period will be extended accordingly.
Bookings
Every booking has a cost associated with it because booked time indicates eventual work and therefore cost for your business.
Cost calculation | Cost distribution | |
Booking | Booked hours x assignee labor cost | The amount of the booking that’s in the future is distributed according to the booking timeframe. |

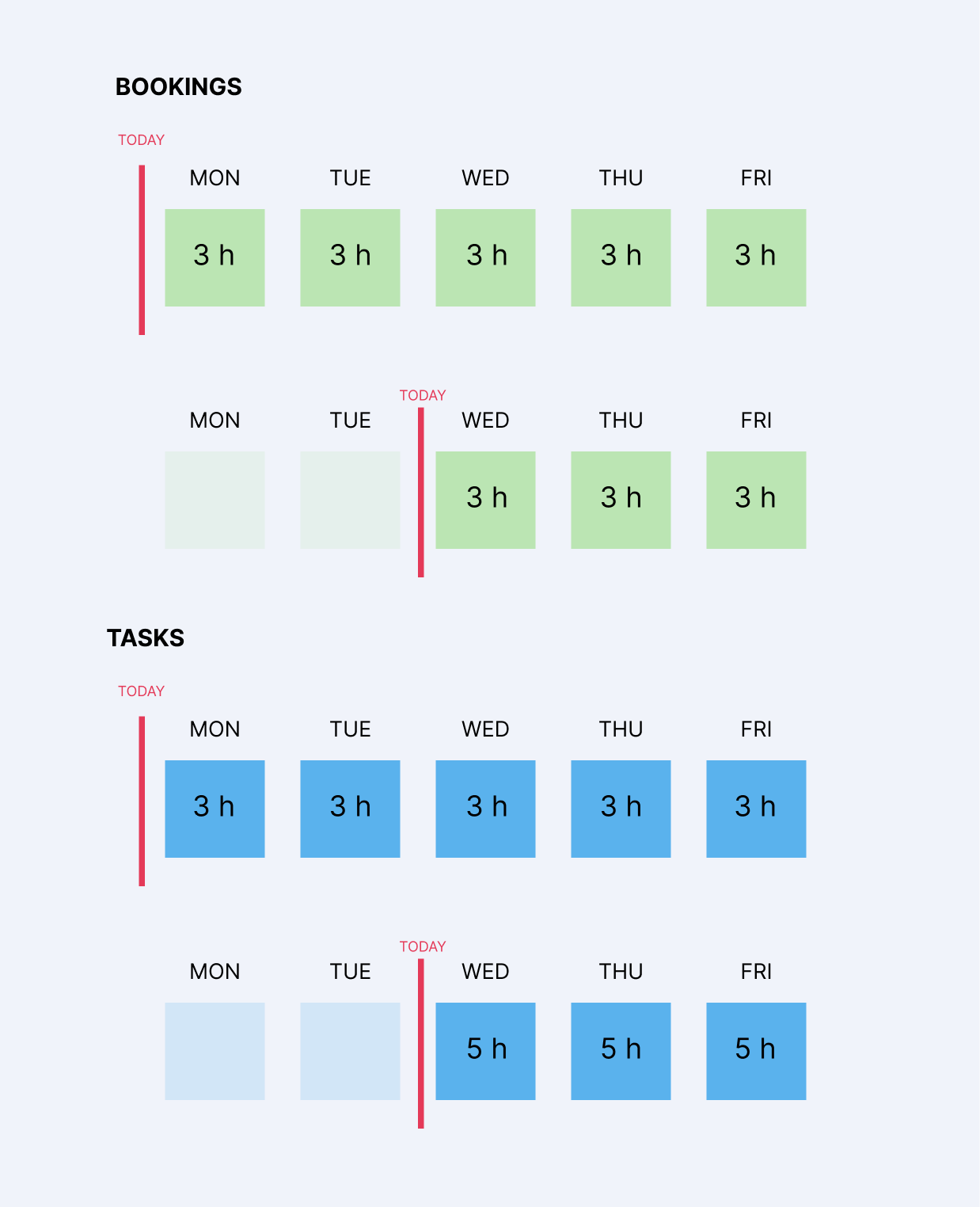

With tasks, you have the past part (completed work) and the future part (remaining work). If you don’t complete the remaining work today, the remaining hours are simply rolled over to the future. The remaining hours remain part of the forecast dimension until you complete them.
Bookings work differently. A booking is considered a reservation for that particular day. If a part of the booking passes, it’s not rolled over. The past part is simply discarded. This is because the past chunk of the booking should already be covered by something actionable, such as an event or a time entry, and reflected in the retrospective data.

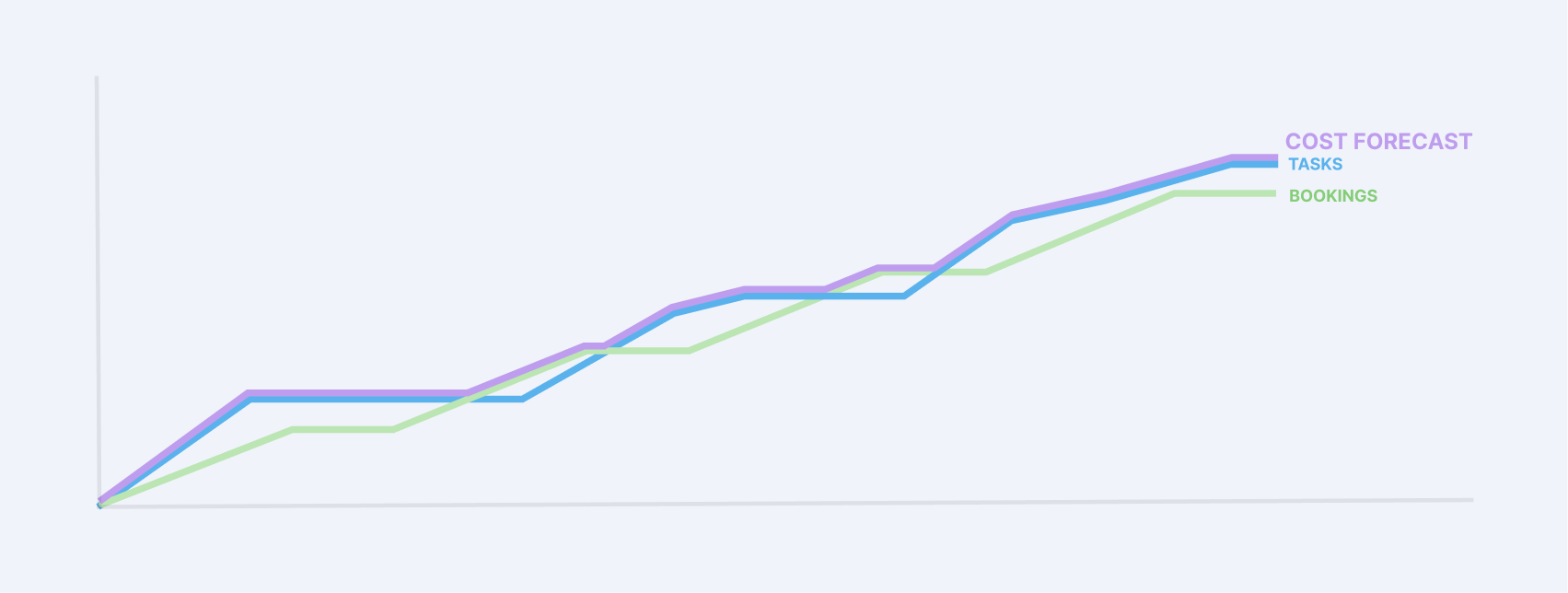

This image illustrates how tasks and bookings differ when it comes to rolling over hours:
Bookings vs tasks
The cost forecast takes both tasks and bookings into account. However, since they essentially reflect the same cost – a two-hour booking should eventually result in two hours' worth of tasks assigned to that same resource – the system is smart enough not to double-report them.
How? The system compares the cumulative cost of booked hours and the cumulative cost of tasks on a user level every single day to determine which one is higher. Whichever is higher at any point in time is reported in the chart.
Cumulative hours => the hours are added on each day.

- For example: You’ve booked 6 hours for Monday, 6 hours for Tuesday, and 6 hours for Wednesday. It accumulates as 6 hours on Monday, 12 hours by Tuesday, 18 hours by Wednesday.
Here's how the cost forecast line is formed based on this cumulative comparison:
Here’s the same logic broken down in a table format:
Outsourced costs
Outsourced costs affect the cost forecast line based on bills, expenses, and purchase orders (optional).
NB! If you want purchase orders to count as cost in the cost forecast, you need to enable it from settings. Open Settings > Sales and finance > Purchases and tick the setting
Consider purchase orders as committed cost.
Document | When it’s reported |
Bill | Reported on the recognition date. If you don’t use recognition dates, then the bill is reported on the bill issue date. |
Scheduled bill | Reported on the bill date
|
Expense | Reported on the recognition date. If you don’t use recognition dates, then the expense is reported on the expense issue date. |
Purchase order | Reported on the purchase order date.
|
As long as the value of the PO is higher than the value of the received bill(s), the system will calculate the cost forecast based on the PO value. This is because the system assumes you will still receive a bill for the unsettled part. Once you mark the PO as settled, only the bill values are counted.
Illustrative example:
Budgeted cost: 1000 EUR |
||||
PO not sent Bill not recieved |
PO issued for 600 PO not settled Bill not recieved |
PO issued for 600 PO not settled Bill received for 300 |
PO issued for 600 PO settled Bill received for 300 |
|
Cost forecast | 0 | 600 | 600 | 300 |
Note! Budget and cost lines report outsourced costs at different points. This is intentional.
Profit forecasting logic
The formula behind forecasted profit depends on the project type:
-
Fixed-price project, i.e. budget is defined
Budget – forecasted cost at completion = forecasted profit -
Time and material project, i.e. budget is not defined
Forecasted revenue based on planned work – forecasted cost at completion = forecasted profit
Permissions – who can see what?
As labor cost is sensitive info, you can hide the cost information from non-relevant users via permission sets. See the below table for reference to fine-tune the permissions:
Permission | Budget health | Profit table |
|
Not available. | Not available. |
|
Only budget-related data and metrics are shown. | Only show Revenue. Profit and cost data is not shown. |
|
Everything is shown. | Everything is shown. |
|
Only budget-related data and metrics are shown. | Revenue and external costs are shown. Profit is not shown. |
|
Everything is shown. | Everything besides labor cost is shown. |
FAQ
Question | Answer |
Why is some of the forecasted cost Unspecified in the breakdown chart? |
Potential reason 1: It’s the leftover cost in your cost forecast. If you have defined a cost budget, your cost forecast will always be at least as high as your cost budget to protect you from an overly optimistic profit margin. So, if some tasks have not been created and assigned yet, you may end up with unspecified costs in your breakdown chart. Potential reason 2: If you have a service-based project and some bookings are not covered by tasks yet, the excess booked time will be categorized as unspecified since the system doesn’t know what service it will turn into. |
Why is my cost forecast in the red zone even if I have just as many tasks as bookings? | Tasks are included in the forecast only based on the remaining time. If the future booking covers more hours than are remaining in the task, the burn chart will indicate potential cost overruns. This is because, theoretically, more time is booked than is necessary to complete the remaining work on the task. Review your bookings and ensure they meet your future needs. |
How does individual allocation affect cost forecasting? |
Allocated time is considered in the calculation based on labor cost. If you leave some of the task hours unallocated, then the unallocated part is NOT considered in the cost forecast. It’s not considered in any forecast in Scoro (i.e., Scoro uses the same logic across forecasts – revenue forecast, utilization forecast, cost forecast). |
Why does my cost forecast exceed my budget forecast? | This might be because bookings are included in the cost forecast but not in the budget forecast. So if a project has more bookings than tasks (for example, early in the project when tasks are not yet planned out), then the cost burn line can exceed the budget burn line as there’s simply more cost data in the system at that point. |
Why does the cost show 0 for a user on a working day, even though there's a booking for that period? | If the user has a day off within that period, no time is booked for that day since the user's availability will be 0. Therefore, no cost for that day. |
